Data Center Electrical Es...
AI

Data Center Electrical Estimating: How to Take Off and Bid the Electrical Scope

Drawer AI
Drawer AI |


Data center electrical estimating presents a different challenge from a typical commercial project. An estimator may need to quantify thousands of nearly identical electrical devices across dozens of drawing sheets, account for redundant power distribution, and develop a competitive bid under a compressed deadline.

Table of Сontents

  1. Why Data Center Electrical Estimating Is Different
  2. What Is in the Data Center Electrical Scope?
  3. Where the Hours Go: The Repetition Problem
  4. A Practical Data Center Electrical Takeoff Workflow
  5. How AI Takeoff Handles Data Center Density at Scale
  6. Common Data Center Estimating Pitfalls
  7. Final Takeaway: Accurate Quantities Make Better Electrical Bids
  8. FAQ

A single data hall can contain hundreds of server racks, each requiring dedicated power connections, branch circuits, and supporting distribution infrastructure. With A/B redundancy, many of those connections must be quantified separately for two independent electrical paths.

The difficulty is not simply counting devices. It is maintaining accurate quantities across equipment schedules, electrical plans, single-line diagrams, and multiple drawing revisions without missing or duplicating scope.

Manual takeoff can consume days before the estimator even begins pricing materials, labor, equipment, and installation requirements.

For teams asking how to estimate electrical for a data center, this guide explains how to take off and bid the electrical subcontract scope, including major distribution equipment, rack-level power, redundant systems, branch circuits, and supporting electrical infrastructure. It also examines how AI-assisted electrical takeoff can reduce repetitive counting and routing work while keeping the estimator responsible for technical review and final pricing.

Why Data Center Electrical Estimating Is Different

A data center is a mission-critical facility, where electrical infrastructure must support continuous operation, equipment availability, and planned maintenance. For an electrical subcontractor, estimating mission-critical electrical work creates requirements that differ substantially from conventional commercial construction.

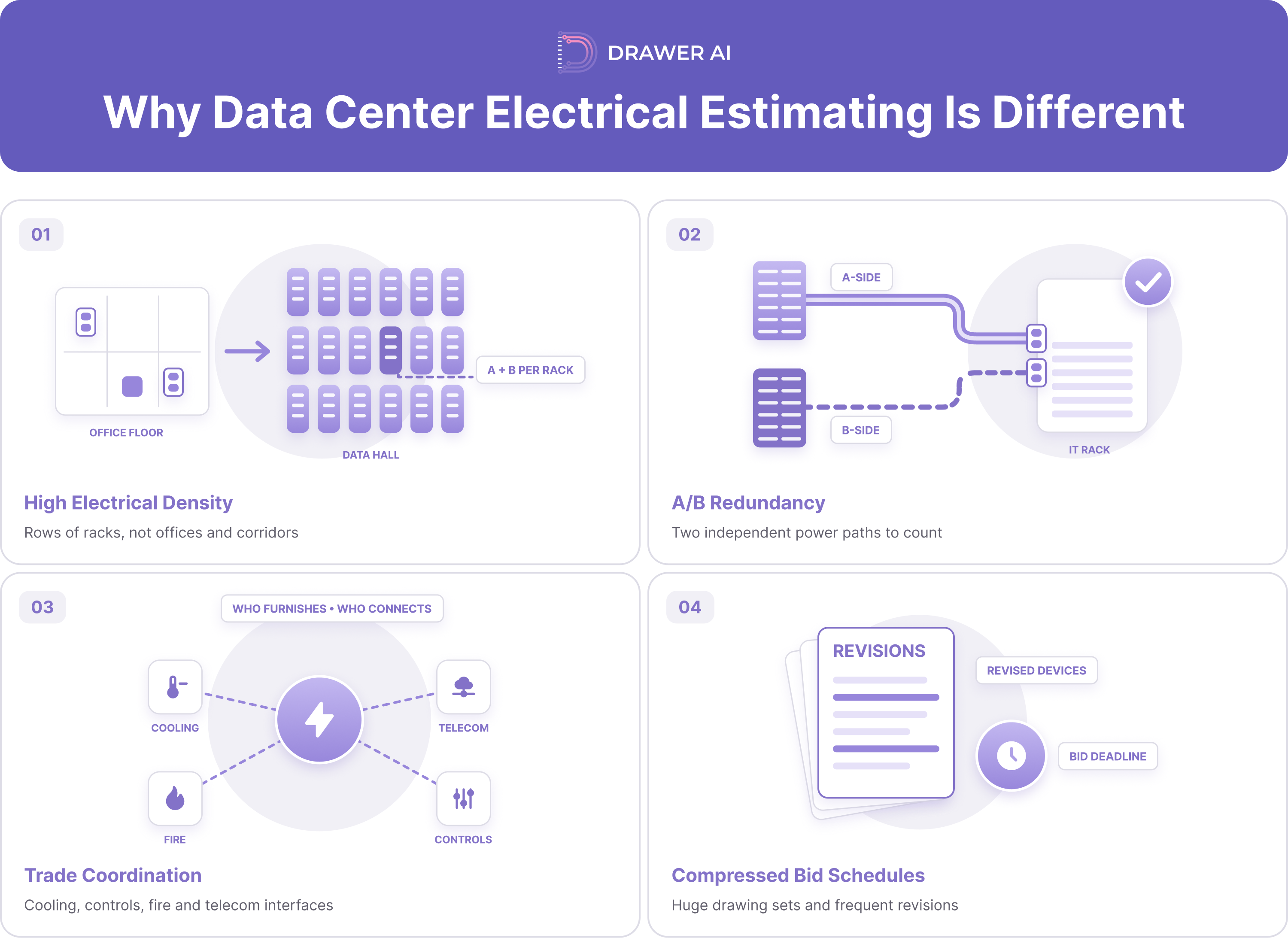

01_why_data_center_estimating_is_different

High electrical density

A standard commercial floor may distribute electrical devices across offices, corridors, and common areas. A data hall concentrates electrical demand within rows of equipment racks. Each rack may require multiple power connections, supported by upstream distribution equipment, dedicated circuits, and carefully planned pathways. The estimator must account for the quantity, type, location, and electrical characteristics of those connections rather than relying on a general allowance per square foot.

Redundant power distribution

Data centers frequently incorporate redundant components and distribution paths. In an A/B arrangement, critical IT equipment can receive power from two separate distribution paths. Each path must be identified and quantified according to the project design.

Uptime Institute distinguishes between redundant components, concurrently maintainable distribution, and fault-tolerant architectures. The actual electrical scope depends on the facility’s specified topology rather than a universal redundancy multiplier.

A rack connection shown on the A-side distribution system cannot automatically be assumed to include its B-side counterpart.

Greater coordination requirements

Data center electrical work interfaces with mechanical cooling equipment, monitoring systems, fire protection, telecommunications, and controls. The estimator must review the division of responsibilities between trades and identify equipment furnished by others but installed or connected by the electrical contractor.

Compressed bid schedules

Large drawing packages and frequent revisions increase the risk of missing changes. A layout revision may affect hundreds of devices, branch circuits, and material quantities simultaneously. The objective is not only to complete the initial takeoff accurately, but also to maintain quantities that can be reviewed and updated efficiently.

What Is in the Data Center Electrical Scope?

The data center electrical scope depends on the contract documents, project delivery model, and procurement responsibilities. Commercial and industrial data center bids commonly include the following systems.

1. Utility service and main electrical distribution

  • Utility service connections and service entrance equipment.
  • Main switchgear and switchboards.
  • Transformers and distribution panels.
  • Main feeders, raceways, and associated terminations.
  • Metering and electrical monitoring equipment.

Determine whether each component is furnished by the electrical contractor, the owner, the utility, or another supplier.

2. UPS and standby power systems

Uninterruptible power supply (UPS) systems maintain critical loads during disturbances and transitions between power sources. Depending on the project, the electrical scope may include UPS equipment, battery connections, bypass arrangements, generator connections, transfer equipment, and associated feeders. Identify the boundaries between equipment procurement, manufacturer installation, electrical installation, testing, and commissioning.

3. A-side and B-side distribution

Quantify redundant distribution systems separately. This includes the relevant switchboards, distribution panels, power distribution units (PDUs), remote power panels (RPPs), busway systems, feeders, and branch connections. Separate takeoff categories make it easier to identify missing equipment and reconcile each path against the electrical one-line.

4. Rack-level electrical connections

  • Rack power connection points.
  • Receptacles and specialized connectors.
  • Flexible whips and branch-circuit assemblies.
  • Overhead busway and tap-off units.
  • Connections to rack PDUs.
  • Raceway and conductor quantities.

Verify whether rack PDUs and IT equipment are owner-furnished or included in the electrical subcontract.

5. Supporting electrical systems

Additional scope may include grounding and bonding, lighting, emergency lighting, equipment-room power, mechanical equipment connections, electrical monitoring, and low-voltage infrastructure. Fire alarm and telecommunications work should be included only where assigned to the electrical contractor.

For code coordination, review the locally adopted edition of NFPA 70 (NEC). Where applicable to qualifying information technology equipment installations, consult NEC 2026 Article 645 [NEC 2023 Article 645]. The adopted edition and project conditions govern; this workflow discussion is not a substitute for code or engineering review. Define the contractual scope and list any assumptions before assigning quantities and prices to the bid.

Where the Hours Go: The Repetition Problem

The most time-consuming part of a data center electrical takeoff is often not the large equipment. It is the repetition of smaller devices and connections across extensive rack layouts.

Consider an illustrative data hall containing 240 equipment racks. Assume each rack requires two dedicated power connection assemblies, one supplied from the A-side system and one from the B-side system.

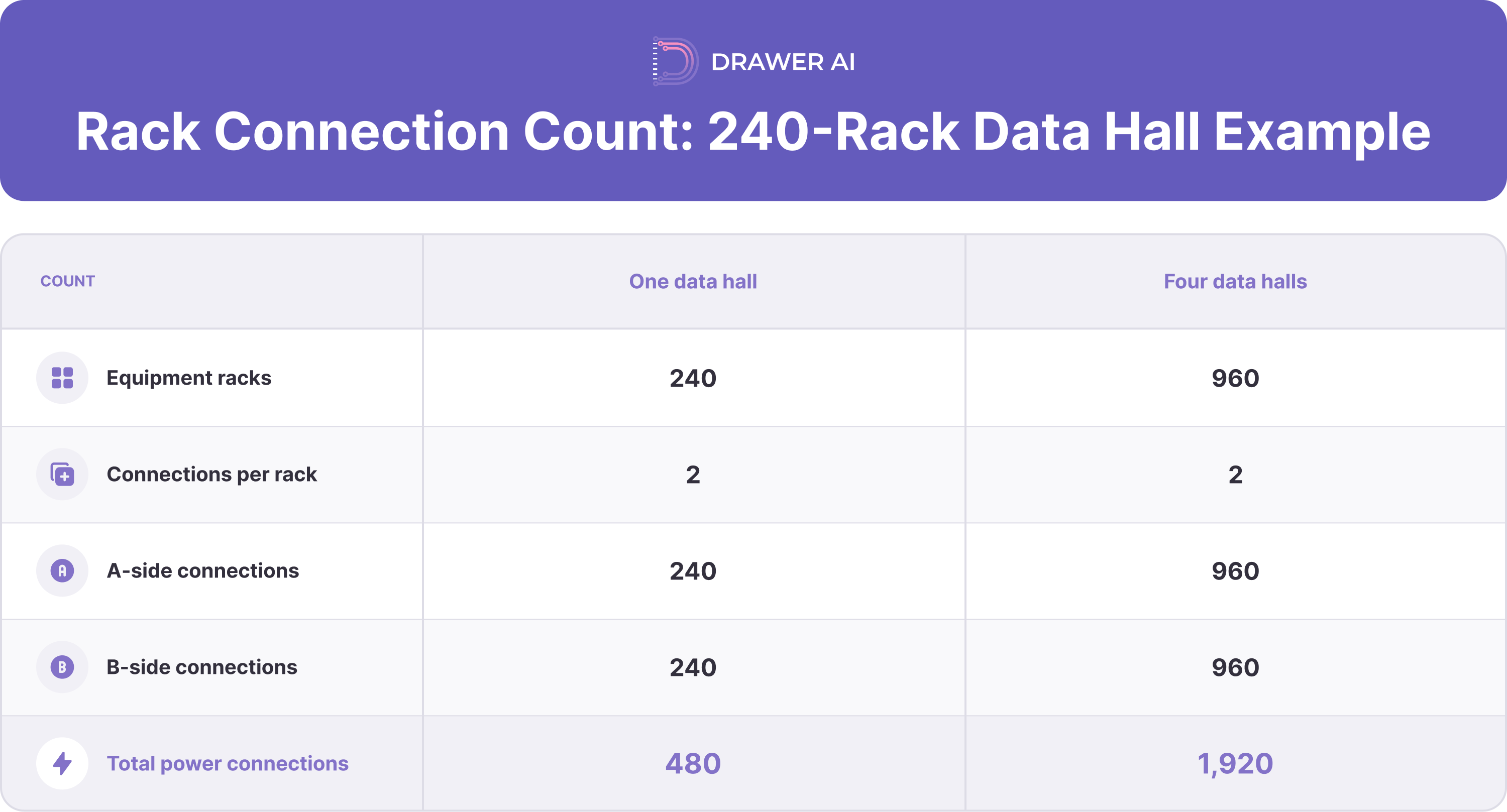

02_rack_connection_count (1)



Across four comparable data halls, that becomes 1,920 rack power connections before upstream distribution, auxiliary devices, and supporting systems. These quantities illustrate the counting workload; they are not a project design.

Each connection may require a receptacle or connector, conductors, a raceway assembly, fittings, identification, termination labor, and testing. A manual estimator must track every connection across multiple sheets, verify its assigned circuit, and ensure the correct distribution path is included.

Simply multiplying a typical rack assembly by the total number of racks can overlook differences in circuit ratings, equipment configurations, connection lengths, and installation conditions. This is where automated detection and structured quantity management become particularly valuable.

For quality control, divide the hall into rack rows or zones and maintain separate A-side and B-side count registers. Cross-check each row total against the rack schedule and mark duplicate representations on enlarged plans. A repeatable quantity register makes it possible to isolate the effect of a changed rack layout without restarting the entire package.

A Practical Data Center Electrical Takeoff Workflow

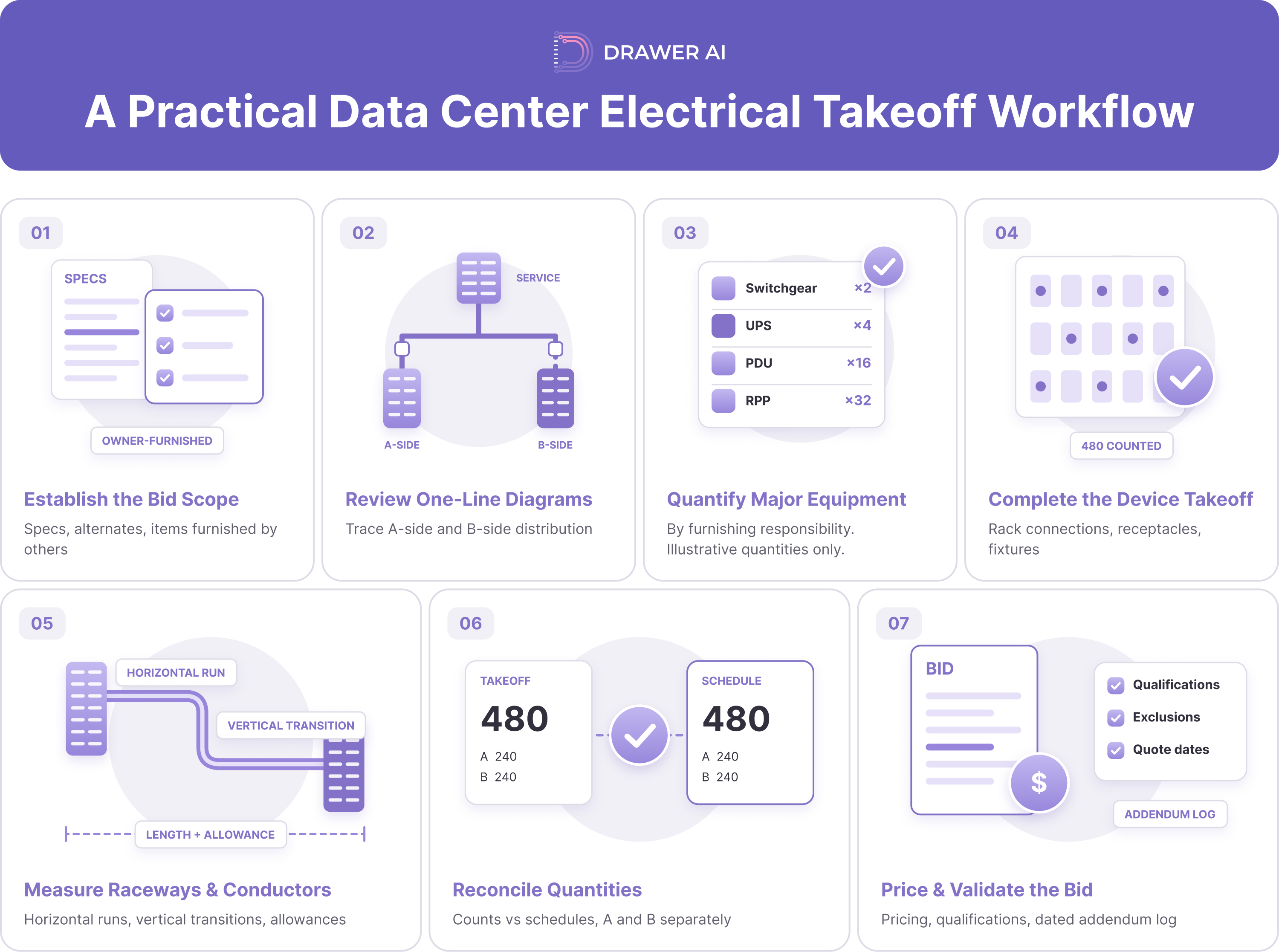

03_data_center_takeoff_workflow

Step 1: Establish the bid scope

Review the specifications, drawing index, alternates, procurement responsibilities, and electrical scope boundaries. Identify owner-furnished equipment, vendor-supplied systems, installation responsibilities, and any required commissioning support.

Step 2: Review the electrical one-line diagrams

Trace the distribution architecture from the service entrance through the critical power systems to the data halls. Identify A-side and B-side distribution, equipment ratings, feeder relationships, and redundancy requirements. Record discrepancies between the one-line diagrams and equipment schedules.

Step 3: Quantify major equipment

Prepare equipment quantities for switchgear, transformers, UPS-related equipment, distribution panels, PDUs, RPPs, and other electrical assemblies. Maintain separate categories for equipment furnished by the contractor and equipment furnished by others.

Step 4: Complete the device takeoff

Count rack connections, receptacles, lighting fixtures, disconnects, and other devices across the electrical plans. Associate each item with its symbol, equipment type, schedule reference, and distribution system.

Step 5: Measure raceways and conductors

Develop routing quantities using the drawings, installation requirements, and anticipated pathway constraints. Account for horizontal runs, vertical transitions, equipment connections, and installation allowances.

Step 6: Reconcile quantities

Compare device counts, panel schedules, branch circuits, equipment schedules, and one-line diagrams. Review A-side and B-side quantities independently before consolidating the estimate.

Step 7: Price and validate the bid

Apply material pricing, labor units, equipment costs, testing, commissioning responsibilities, overhead, and margin. Document qualifications, exclusions, alternates, and unresolved scope assumptions before submission.

Before release, perform a final drawing-revision check and compare the estimate with its exclusions and supplier quotation coverage. Flag unresolved design assumptions in the bid rather than silently filling gaps with generic allowances. Confirm quotation validity dates, long-lead equipment assumptions, and subcontractor interfaces before submission. Maintain a dated change log identifying each addendum, its affected drawing sheets, the revised quantities, and the person responsible for review.

For the broader process, see our Electrical Estimating Guide: Commercial & Industrial [2026].

How AI Takeoff Handles Data Center Density at Scale

AI-assisted data center electrical estimating addresses a major bottleneck: converting extensive electrical drawing packages into structured quantities. Instead of manually identifying every repeated symbol, estimators can use automated detection to establish an initial count and focus on exceptions, system assignments, and project-specific requirements.

Automated device detection

At Drawer AI, we analyze PDF electrical drawings to identify and quantify lighting fixtures and power devices. Our workflow links detected items to tags, panels, circuit information, and schedules for review. Estimators still verify device types, similar symbols, and project-specific assignments.

Branch circuit routing

Counting devices is only part of the takeoff. Our branch-routing tools generate proposed conduit paths, support conductor sizing, and calculate voltage drop. For data center work, estimators must verify these results against the specified A/B architecture, equipment assignments, and installation constraints. Automated routing does not independently validate a mission-critical electrical design.

Structured quantity reports

Our reviewed quantities can be exported in Excel reports and marked-up PDFs to support the contractor’s pricing workflow. Organize and review outputs by floor, area, equipment category, and distribution path.

Faster revisions and quality control

Structured digital quantities provide a manageable starting point when drawings change. A new rack configuration may alter circuit assignments, conductor quantities, and routing assumptions, all of which require technical review.

When an addendum changes an equipment row, compare the revised sheet with the previous takeoff, verify its tags and panel assignments, and record the drawing revision used for each quantity.

Where the estimator remains responsible

  • Interpreting specifications and contractual scope.
  • Verifying redundant distribution requirements.
  • Reviewing feeder and equipment requirements.
  • Validating installation methods and material assemblies.
  • Confirming code compliance and design assumptions.
  • Obtaining quotations and assigning labor.
  • Preparing final bid qualifications and pricing.

At Drawer AI, we automate repetitive electrical takeoff work—not the entire engineering, procurement, or commercial bidding process.

Review our takeoff and branch-routing features and watch our product demonstrations. Estimators remain responsible for project-specific feeder takeoff, procurement packages, and critical-system interpretation.

Common Data Center Estimating Pitfalls

  1. Missing the redundant distribution path. Count and verify A-side and B-side requirements independently.
  2. Double-counting repeated devices. The same installed item may appear on plans, enlarged details, and schedules.
  3. Assuming every rack is identical. Power requirements, connection types, and circuit configurations may differ.
  4. Overlooking installation accessories. Include applicable raceway, conductors, fittings, supports, identification, and terminations.
  5. Misinterpreting procurement responsibilities. Separate owner-furnished from contractor-furnished equipment.
  6. Underestimating commissioning requirements. Account for testing, documentation, integration, and applicable participation in systems testing.
  7. Using outdated drawings. Reconcile against the latest issued package, addenda, and RFI responses.

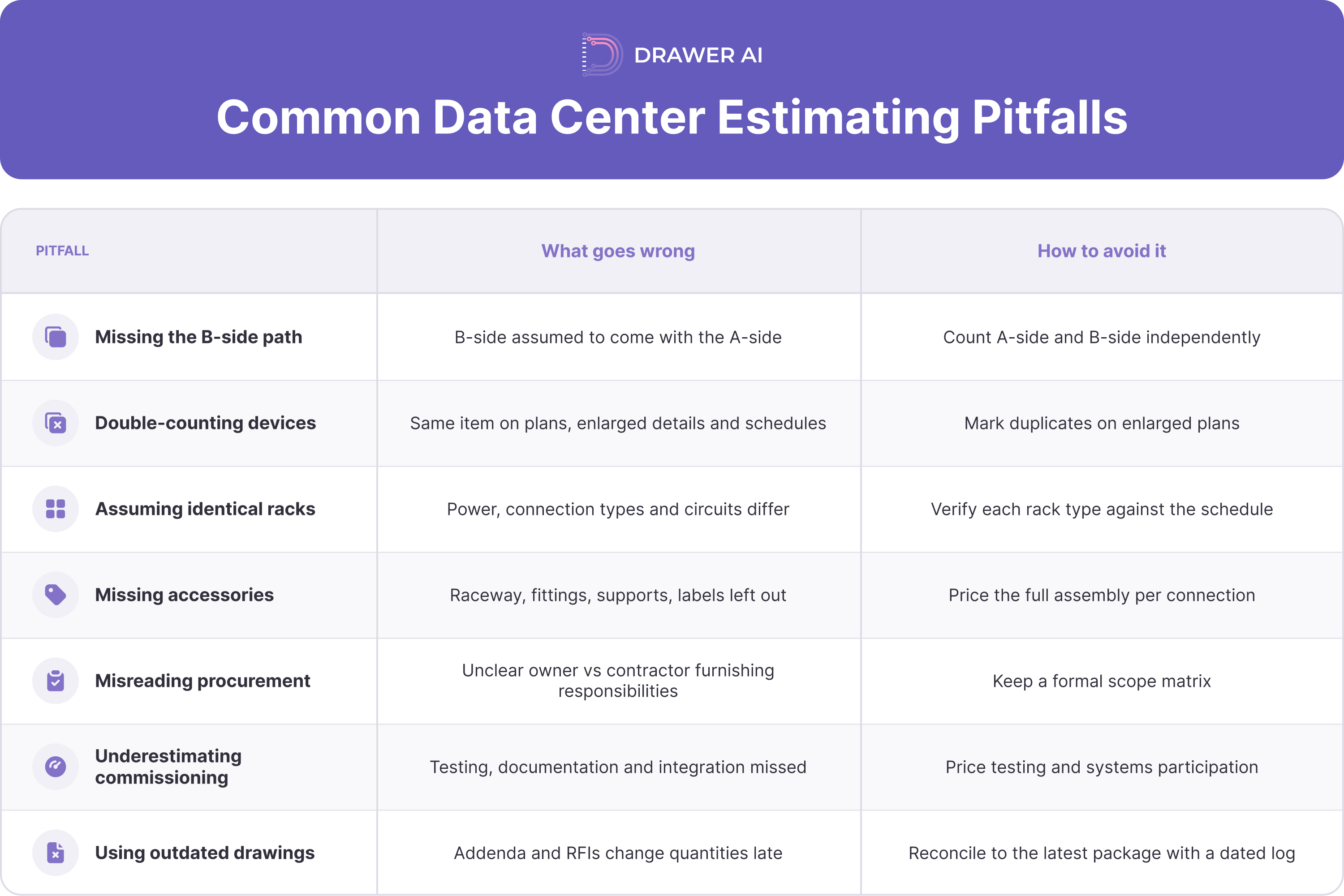

04_common_data_center_estimating_pitfalls

Also check whether equipment procurement, factory services, temporary power, energization, and integrated systems testing are priced in the right package. Maintain a formal scope matrix and a dated addendum log so that late changes can be traced to revised quantities and qualifications. Review potential change-order exposure before bid release.

A reliable bid depends on complete quantities, clear scope boundaries, and documented assumptions.

Final Takeaway: Accurate Quantities Make Better Electrical Bids

Data center electrical estimating is a quantity-management and scope-control challenge as much as a pricing exercise. The complexity comes from combining large distribution systems, redundant power architecture, dense rack layouts, and repeated electrical connections within one coordinated estimate.

An effective workflow separates A-side and B-side quantities, reconciles counts against schedules, and establishes reliable material quantities before pricing. AI-assisted takeoff can reduce repetitive counting and routing while preserving the estimator’s role in technical review and bid preparation.

Ready to streamline your next data center electrical takeoff? Explore Drawer AI or book a demonstration to see how our device detection and branch routing support your next commercial or mission-critical electrical bid.

FAQ

What is included in a data center electrical scope?

 A data center electrical scope generally includes service and distribution equipment, feeders, transformers, UPS-related infrastructure, standby power connections, rack-level distribution, branch circuits, grounding, bonding, lighting, and supporting systems. Confirm owner-furnished items, manufacturer responsibilities, mechanical power connections, and testing boundaries against the contract documents.

How is data center electrical estimating different from a normal commercial building?

 A data center concentrates critical electrical loads in dense rack rows, often with specialized distribution equipment and separate power paths. Reconcile takeoff quantities across one-lines, equipment and panel schedules, and rack layouts. Drawing revisions can change hundreds of similar connections, so a dated drawing register and traceable counts are especially important.

What is A/B redundancy, and how does it affect the takeoff?

 A/B redundancy describes separate electrical distribution paths serving critical equipment as specified in the design. Count A-side and B-side equipment, busway, branch circuits, and rack connections independently. Do not simply double the entire scope: topology and shared infrastructure vary. Check all assignments against the one-lines and schedules.

How do you estimate the electrical for a data center fast?

 Define the electrical subcontract scope and current drawing register first. Trace the one-lines; quantify major equipment; then count devices and rack connections by area and distribution path. Measure raceways and conductors, reconcile schedules, and price materials, labor, and testing. AI-assisted takeoff can reduce repetitive counting, but exceptions and revisions still need review.

Can AI do a data center electrical takeoff?

 Yes, for parts of the workflow. AI-assisted tools can detect recurring device symbols on PDF drawings, associate tags and circuit data, generate proposed branch routing, and export structured quantities. They cannot independently confirm every A/B assignment, contractual scope boundary, design assumption, or installation condition. The estimator validates the results and prepares the final bid.

Does Drawer AI calculate data center construction cost?

 No. At Drawer AI, we support the electrical subcontract estimate through device detection, branch routing, quantity review, and exports; we do not calculate the owner’s total data center capital cost. Contractors still obtain vendor quotations, apply material and labor pricing, account for installation conditions, define commissioning responsibilities, and set overhead and margin.
