Grounding and Bonding Tak...
AI

Grounding and Bonding Takeoff: What to Quantify for a Commercial Electrical Bid (NEC 250)

Drawer AI
Drawer AI |

Grounding and bonding takeoff is easy to under-scope in a commercial electrical bid. A ground rod symbol may be visible on the site plan, while conductor routes, structural steel connections, bonding hardware, and testing obligations are scattered across electrical details and Division 26 specifications. A missed connection can mean more than a material adjustment: grounding deficiencies may delay inspection, energization, or turnover.

Table of Сontents

  1. Grounding vs Bonding in One Paragraph
  2. What to Quantify in a Grounding & Bonding Takeoff
  3. Where the Money and the Code Risk Are
  4. A Practical Grounding Takeoff Workflow
  5. How AI Takeoff Helps — and Where the Estimator Takes Over
  6. FAQ

For an estimator preparing an electrical grounding takeoff, the question is not simply whether the design shows a ground. It is what to count, what to measure, what another trade supplies, and how to price installation. This guide covers service electrodes, grounding electrode conductors, equipment grounding conductors, bonding jumpers, and specialty grids, with NEC Article 250 references that matter when assembling a defensible commercial or industrial bid.

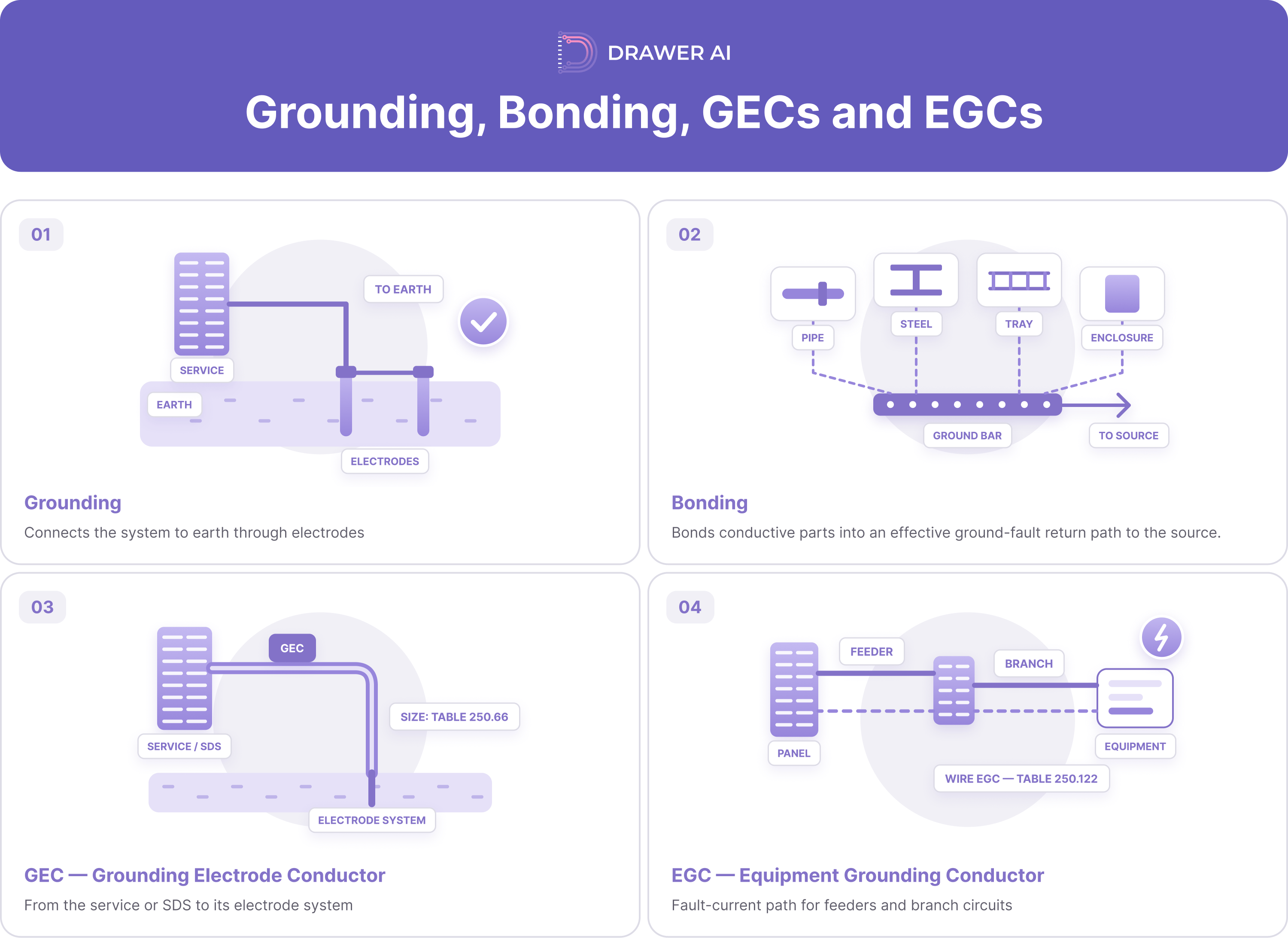

01_grounding_vs_bonding

This is a takeoff and pricing workflow, not a replacement for the approved engineering design, project specifications, or the NEC edition adopted by the authority having jurisdiction (AHJ).

Grounding vs Bonding in One Paragraph

Grounding connects a system or equipment to earth through a grounding electrode system; bonding establishes electrical continuity among conductive parts to help create an effective ground-fault current path. A grounding electrode conductor (GEC) connects the applicable system to its electrode system. An equipment grounding conductor (EGC), whether a wire or a permitted wiring method, serves the equipment fault-current path. Those functions create different takeoff quantities. A service GEC run does not replace the EGC quantities associated with feeders and branch circuits. NEC Article 250 addresses these functions for the conventional commercial power installations covered here. Separate each path, connection, and installation assembly before assigning conductor sizes or labor units.

What to Quantify in a Grounding & Bonding Takeoff

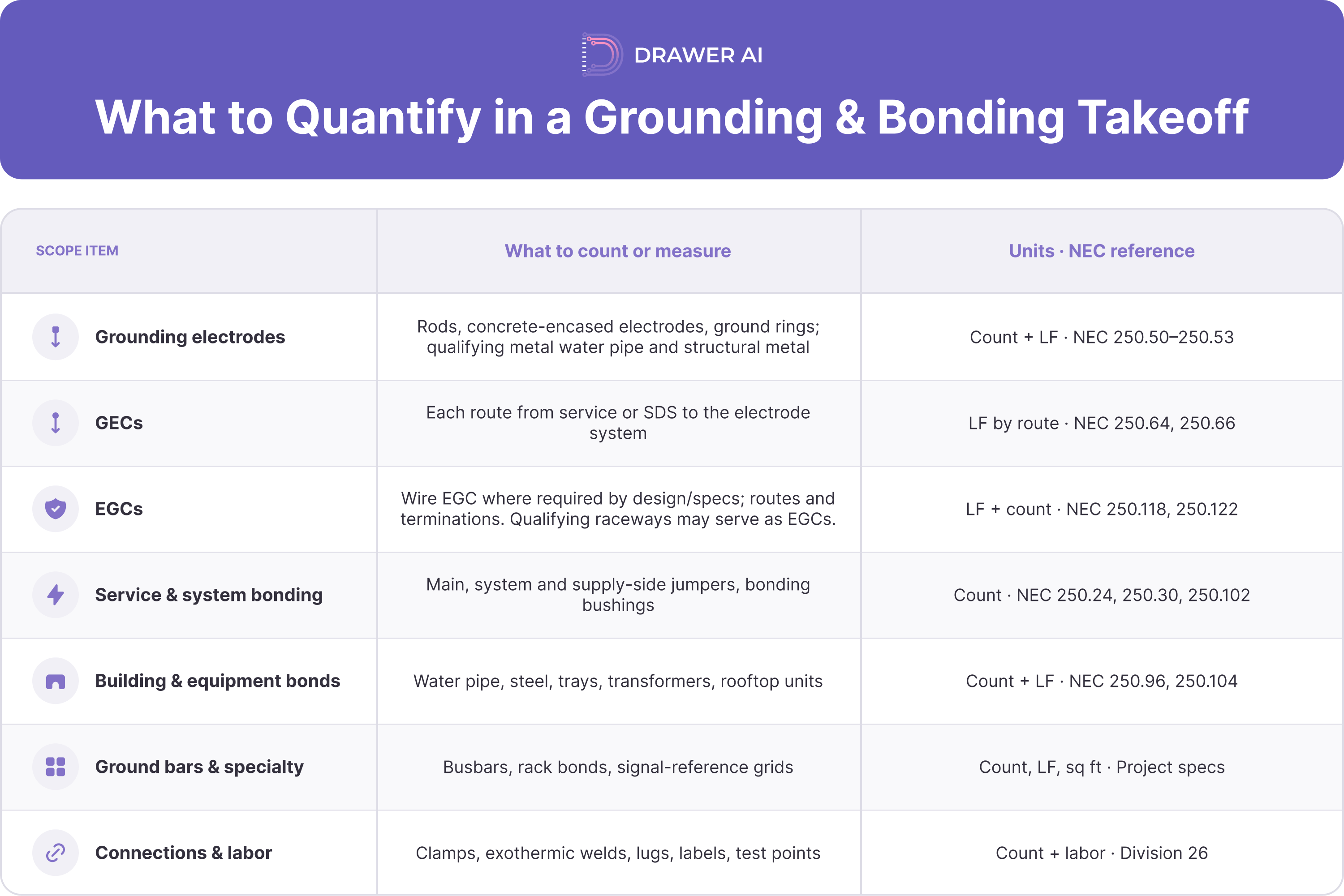

02_what_to_quantify_grounding_bonding

To determine what to include in a grounding takeoff, read plans, one-lines, site details, equipment schedules, and Division 26. Count each assembly once; measure conductor routes, not a blanket allowance. Build this scope register:

  • Grounding electrodes and electrode system: count rods and specified connections to qualifying metal water pipe, concrete-encased electrodes, structural metal, and ground rings or grids. Measure ring/grid conductors in linear feet; carry excavation and backfill separately. Check NEC 250.50–250.53 and project details.
  • Grounding electrode conductors (GECs): measure each applicable route between the service or separately derived system and its grounding electrode system, including vertical changes, sleeves, physical protection, and terminations. Record the approved material and size; verify installation and sizing under NEC 250.64 and 250.66 instead of estimating size from an electrode symbol.
  • Equipment grounding conductors (EGCs): measure wire EGC footage by feeder or branch-circuit route where required, and count terminations at panels and equipment. Confirm permitted wiring methods and overcurrent devices under NEC 250.118 and 250.122. Do not automatically add a duplicate wire EGC when a qualifying metallic raceway is shown; check design and specifications.
  • Service and system bonding: count main bonding jumpers, system bonding jumpers at separately derived systems, supply-side bonding jumpers, specified bonding bushings, and related connection hardware. Tie every item to its one-line location and review NEC 250.24, 250.30, and 250.102 as applicable.
  • Building and equipment bonds: count specified bonds to metal water piping, structural steel, cable trays, enclosures, transformers, rooftop equipment, and mechanical equipment when assigned to the electrical subcontract. Measure jumpers and record lugs, clamps, and access requirements. Review NEC 250.96 and 250.104 and any applicable equipment or system provisions.
  • Ground bars and specialty systems: count ground busbars, stand-offs, rack bonds, and telecommunications or signal-reference grids within bid scope. Record grid area in square feet, dedicated conductor lengths in linear feet, and supports and connections by count. Specialty grids are not universal Article 250 requirements.
  • Connections and installation labor: count listed clamps, irreversible connections or exothermic welds where specified, lugs, bonding screws, labels, inspection points, and test locations. Include lifts, core drilling, concrete work, corrosion protection, excavation, and coordination as separate cost drivers.

Keep separate takeoff codes for electrodes, GECs, EGCs, bonds, specialty systems, and testing. If a detail is repeated on a one-line and plan, reconcile the drawings to one installed assembly rather than counting it twice.

Where the Money and the Code Risk Are

Copper footage and connection labor can outweigh the visible device count. A ground rod may be easy to mark, but its associated conductor, excavation, clamp, access, and test obligation are not captured by the symbol alone. A building-wide ground ring, long feeder EGCs, high-level steel bonds, or a specified signal-reference grid can drive materials and labor. For every item, distinguish conductor length from raceway length, and apply route or waste allowances only where justified by installation conditions.

Sizing mistakes also change costs. NEC Table 250.66 is the general GEC sizing reference based on the relevant service or system conductors, with electrode-specific provisions. Table 250.122 addresses wire EGC sizing based on the upstream overcurrent device and applicable adjustments. The tables are not interchangeable; verify whether circuit conductor upsizing, parallel raceways, or project-specific requirements change the material count. Use the approved design and adopted code rather than reproducing a generic size chart in the estimate.

Installation details carry inspection exposure. An inaccessible electrode connection, unsuitable fitting, omitted steel bond, or missing jumper at a separately derived transformer can require rework before energization. Price specified inspections and testing, including access to concealed work and documentation. Record whether utility, owner, concrete, structural, mechanical, or low-voltage contractors supply each item so exclusions and overlaps are visible.

NEC grounding and bonding requirements set the code baseline for the applicable installation; Division 26 can require additional ground bars, conductors, installation methods, or testing. The AHJ and locally adopted edition govern code compliance.

A Practical Grounding Takeoff Workflow

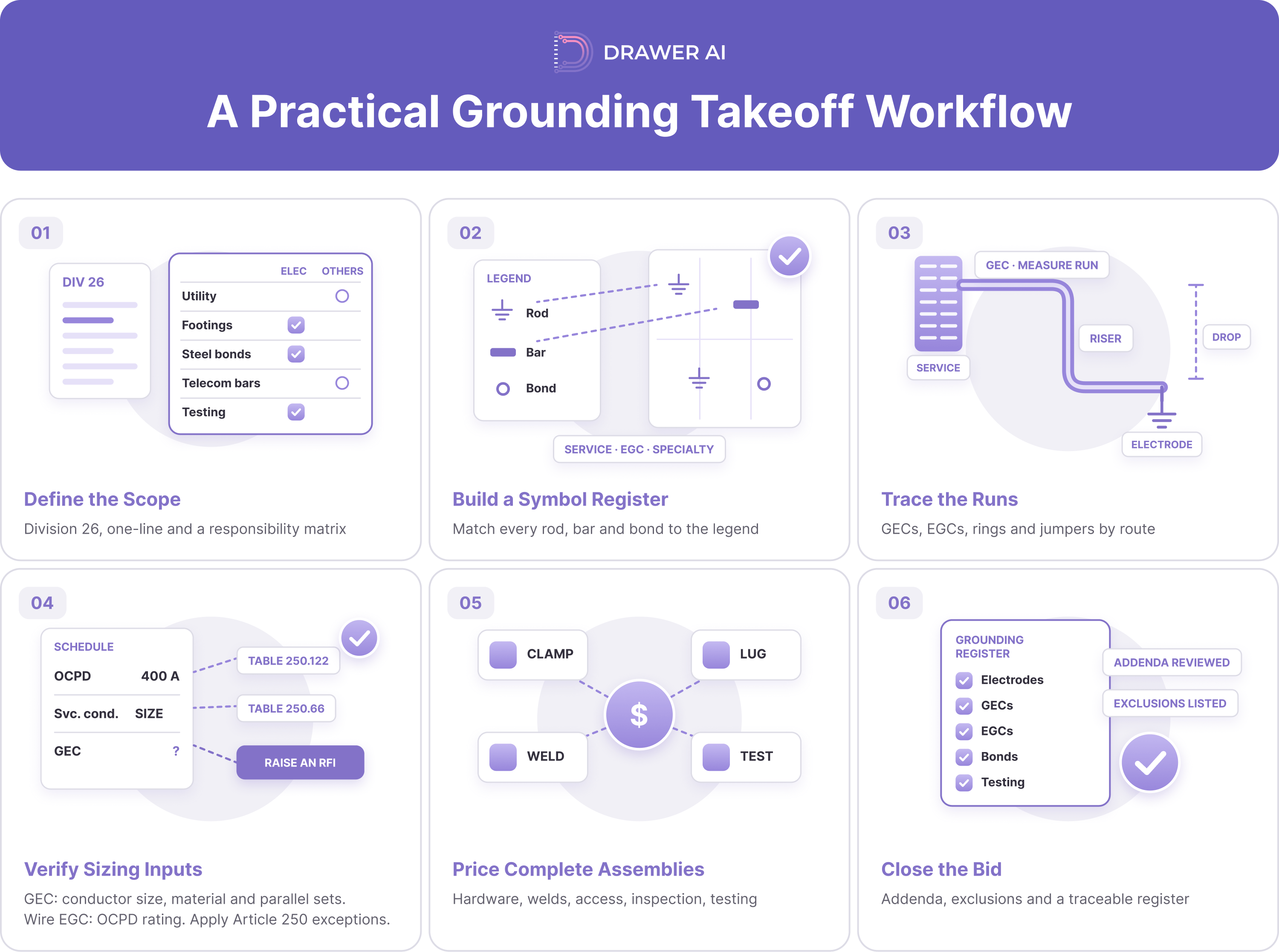

03_grounding_takeoff_workflow

Step 1 — Define scope. Read Division 26, the one-line, grounding details, site plan, and coordination notes. Create a responsibility matrix covering utility work, footing electrodes, steel bonds, telecommunications bars, and testing.

Step 2 — Build a symbol register. Match each ground rod, bar, bonding point, and electrode notation to the legend. Separate service grounding, feeder and branch-circuit EGCs, and specialty grounding systems.

Step 3 — Trace the runs. Measure GECs, wire EGCs, ground rings, and bonding jumpers by conductor type and physical route. Include risers, drops, offsets, and documented routing assumptions, but keep conductor, conduit, and excavation quantities distinct.

Step 4 — Verify sizing inputs. Check approved schedules, equipment ratings, upstream overcurrent devices, and the applicable Article 250 provisions. If a conductor size or bonding detail is missing, raise it for qualified design review instead of guessing.

Step 5 — Price complete assemblies. Add connection hardware, supports, corrosion protection, access equipment, excavation, welding, terminations, inspection, and testing labor. Reconcile repeated drawing details before extending unit costs.

Step 6 — Close the bid. Cross-check against the one-line and equipment schedule, review addenda and the adopted NEC edition, and document exclusions and trade responsibilities. Retain a traceable electrical grounding takeoff register for bid clarifications and change orders.

For the wider bid sequence, see our commercial and industrial electrical estimating guide.

How AI Takeoff Helps — and Where the Estimator Takes Over

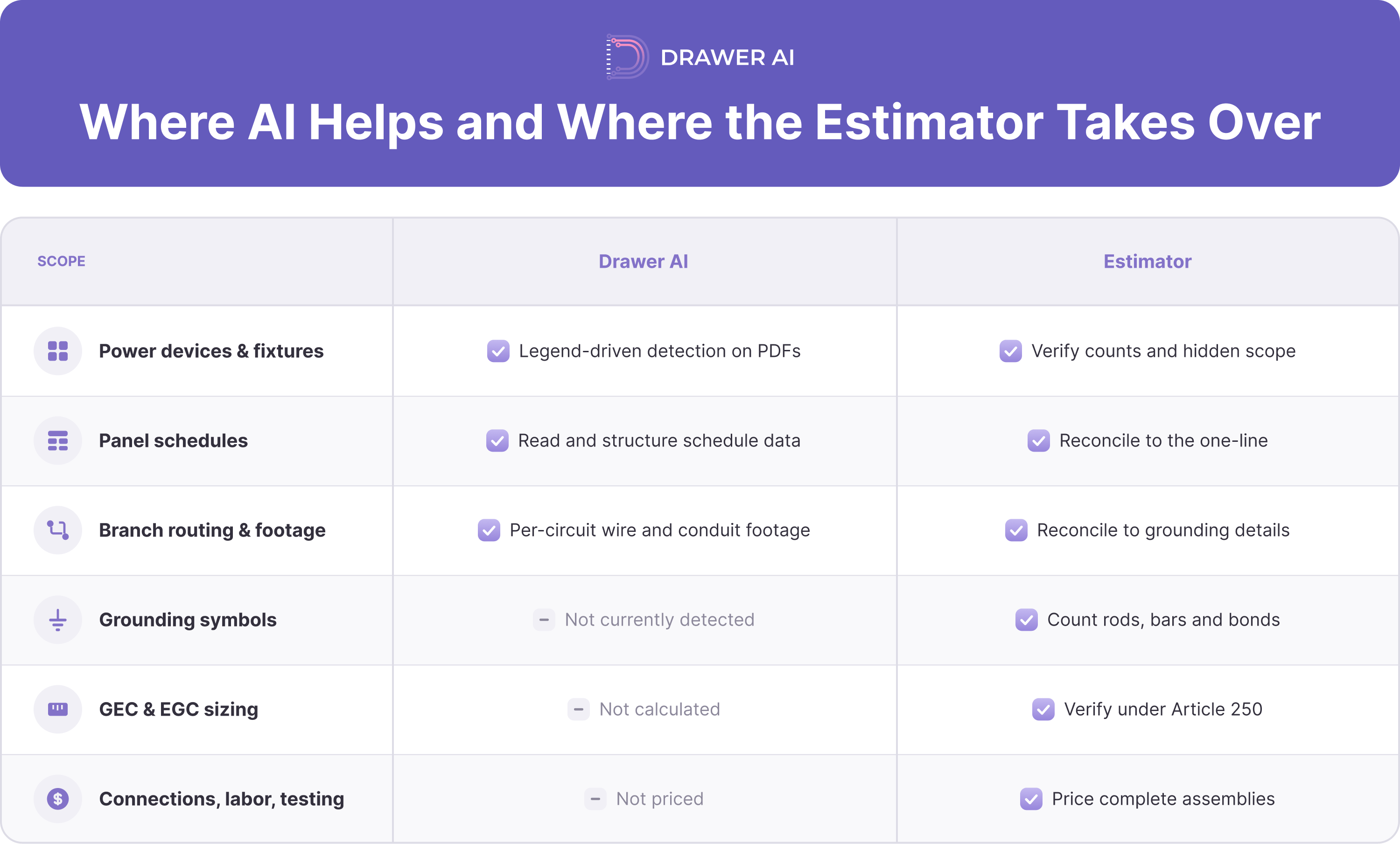

04_ai_takeoff_vs_estimator

At Drawer AI, we use legend-driven detection on PDF electrical drawings to count power devices, lighting fixtures, and panel schedules, and we generate branch-circuit routing with per-circuit wire and conduit footage. That routed output gives estimators circuit-level conductor and footage data to reconcile against the one-line, grounding details, and equipment schedules. This gives estimators a starting point to reconcile against the one-line, grounding details, and equipment schedules.

We do not calculate Article 250 grounding requirements or independently size GECs or EGCs. The estimator identifies hidden scope, verifies conductor sizes and bonds with the approved design, and prices connections, specialty installations, labor, and testing. A symbol count is not a complete grounding estimate.

For circuit conductor and raceway methods, see our conductor and raceway sizing guide. For conduit-fill and load-calculation references, see our NEC reference guide (its load-calculation citations use 2023 numbering). Verify GEC and EGC sizing separately under Article 250, including Table 250.122 for wire EGCs.

 Ready to speed up the device-counting and circuit-quantity portion of your next commercial bid? Explore our electrical takeoff workflow or book a demo of Drawer AI.

FAQ

What is a grounding and bonding takeoff?

 A grounding and bonding takeoff lists electrodes, GECs, EGCs, bonding jumpers, ground bars, connectors, and specified testing. For pricing in a commercial electrical bid, it separates device counts, routed conductor lengths, and installation labor.

What do you include in a grounding takeoff?

 Count electrodes, ground bars, clamps, lugs, and bonding points. Measure GECs, wire EGCs, rings, grids, and jumpers along their routes. Include supports, excavation, access, terminations, inspection, and testing; assign each item to its trade to avoid double counting. Include wire EGC area in conduit fill, but not in current-carrying-conductor ampacity adjustments.

What NEC article covers grounding and bonding?

 NEC Article 250, in Chapter 2, covers grounding and bonding for these commercial power systems in the 2020, 2023, and 2026 editions. Follow the AHJ-adopted edition, project specifications, and applicable system-specific provisions.

What is the difference between grounding and bonding?

 Grounding connects a system to earth through electrodes; bonding connects conductive parts to support an effective fault-current path. For bids, count electrode connections, conductors, jumpers, clamps, terminations, and related installation labor separately. A ground-symbol count alone misses bonding scope.

What size is the grounding electrode conductor?

 Check the approved design and NEC Table 250.66, including electrode-specific rules; a grounding electrode conductor size chart is not a universal specification. If you are checking EGC meaning in a drawing legend, it stands for equipment grounding conductor; wire EGC sizing follows Table 250.122. Electrode type and design still govern GEC selection for each applicable installation.

Can AI count grounding devices on a drawing?

 Drawer AI detects legend-mapped power devices, lighting fixtures, and panel schedules, and supplies per-circuit wire and conduit footage. It does not currently detect grounding-specific symbols, calculate Article 250 requirements, or independently size GECs or EGCs, so estimators verify grounding-device counts and hidden scope on each project. We do not detect unshown connections, calculate Article 250 requirements, or independently size GECs or EGCs. Estimators verify hidden scope and installation details on each project.

Final Takeaway: Carry the Entire Grounding Scope Into the Bid

 A reliable bid separates visible grounding devices from conductor lengths, connection hardware, specialty systems, and labor. Build a traceable register for electrodes, GECs, EGCs, bonds, and testing; then reconcile it with the approved design, Article 250, project specifications, and trade responsibilities.
