MEP Coordination and Clas...
AI

MEP Coordination and Clash Detection: How Electrical Contractors Can Stop Losing Space

Drawer AI
Drawer AI |

It is Tuesday morning. The weekly coordination meeting is on. Fifteen people from different trades sit around one screen. They are looking at a crowded 3D model of a third-floor corridor. The mechanical coordinator points at a problem. A bank of two-inch electrical conduits runs straight through a main supply air duct.

Table of Сontents

  1. What Is MEP Coordination?
  2. Understanding Clash Detection
  3. Hard Clashes
  4. Why Electrical Teams Lose the Space War
  5. Conduit Looks Like the Easiest Thing to Move
  6. Electrical Starts Modeling Last
  7. The Real Cost of Entering Coordination Late
  8. Best Practices That Keep You Winning
  9. Conclusion
  10. FAQs

What happens next is always the same. The mechanical team says the duct cannot move because of static pressure and beam clearance. Then everyone looks at the electrical coordinator. The answer never changes. The electrical team has to reroute the conduit.

If you are a commercial electrical contractor, you have lived this scene on hospitals, office towers, data centers, and schools. The electrical trade keeps giving up space. Conduit gets pushed into tight corners. Extra bends get added. The field crew pays for it later in labor hours.

This is not bad luck. It comes from how electrical design data is made and the order in which trades model. Understand that, and you can get into the model first and stop losing the good routing space.

What Is MEP Coordination?

MEP coordination is the process of fixing space conflicts between mechanical, electrical, plumbing, fire protection, and structural systems inside a shared digital model before anyone builds anything in the field. On big commercial jobs like hospitals and multi-story offices, hundreds of systems have to fit inside limited ceiling space, structural zones, and utility shafts.

The goal is simple. Find the conflicts early and fix them on screen. That avoids field rework, wasted material, and schedule delays. VDC engineers from every trade work on one combined model and spot where systems overlap or break code.

But the model is more than a reference. It is the battleground. The trade that fills its space first keeps that space in the field. That fact explains why electrical keeps losing.

Understanding Clash Detection

Clash detection is a software check that finds conflicts between building systems in a combined 3D model. Teams load every trade model into a tool like Autodesk Navisworks and run automatic scans. The scan flags every spot where parts touch or break a required clearance. The point is to catch every problem before fabrication. A clash fixed in the model costs a few hours. In the field it means cutting out finished work.

Clashes come in three types. Each one needs a different response.

Hard Clashes

A hard clash happens when two physical parts sit in the same space. A cable tray running through a steel column. A conduit bank passing through a supply duct. A busway crossing a sprinkler main. These are physically impossible to build. They must be fixed before fabrication. When a hard clash reaches the field, it is the most expensive kind to correct. One missed hard clash can cost thousands of dollars in rework, crew downtime, and lost schedule.

Soft Clashes

A soft clash happens when a part gets inside a required clearance zone, even if nothing is touching. For electrical work, this is a code issue. NEC Article 110.26 sets working space depths, widths, and heights around panels, switchboards, and motor control centers. If a pipe or a wall pushes into that space, it is a soft clash and it must be fixed.

Soft clashes get missed in early reviews all the time. Then they cause real problems after the building opens. A panel blocked by piping cannot be serviced safely. Catching these on screen is far cheaper than fixing them later.

Workflow Clashes

Workflow clashes, or 4D clashes, are about sequence, not geometry. Everything may fit in the model, but the install order creates the problem. One trade needs access to a ceiling that another trade already closed up. A delivery route is blocked by finished work. Clash detection software cannot see these. They only get solved by planning install sequences and logistics together.

Why Electrical Teams Lose the Space War

When a conflict shows up in a meeting, the electrical contractor is almost always the one asked to move. There are two reasons for this, and they feed each other.

photo_2026-07-24_12-29-23

Conduit Looks Like the Easiest Thing to Move

Compared to ductwork, chilled water piping, gravity drains, or steel, conduit is flexible. A big supply duct has fixed sizes driven by airflow. A waste line needs constant slope. A beam does not move at all. EMT can be offset, split into smaller runs, or bent around obstacles with normal field tools.

So, the room picks the easy answer. Move the conduit. That clears the clash on screen but creates a chain of costs in the field. More offsets, longer runs, extra pull boxes, tougher wire pulls, and lower productivity. The model looks clean. The electrical contractor pays the bill.

Electrical Starts Modeling Last

This is the real cause, and almost nobody talks about it. It comes from how each trade gets its design information.

Mechanical and plumbing engineers’ hand over real geometry. A mechanical drawing shows a duct as a box, say 24 inches by 12 inches. The detailer can model it right away. Pipe sizes and slopes are just as clear.

Electrical drawings are not like that. They are abstract. Symbols, circuit numbers, panel schedules, and notes. A lighting plan shows a fixture symbol and a circuit tag. A power plan shows a receptacle and a reference to a schedule. Nothing shows the actual conduit routing, raceway sizes, or rack layouts.

So, the electrical detailer cannot just copy the design into a model. They have to read the intent, group circuits, run fill calculations, and route every foot from zero. That takes days or weeks. Meanwhile, mechanical models its main ducts, plumbing finishes its risers, and fire protection takes the rest of the ceiling. When electrical finally shows up, the best routes are gone.

The Real Cost of Entering Coordination Late

Starting last costs money in ways you can measure. When other trades set their layouts first, the electrical detailer has to build around a fixed grid of ducts, pipes, and steel.

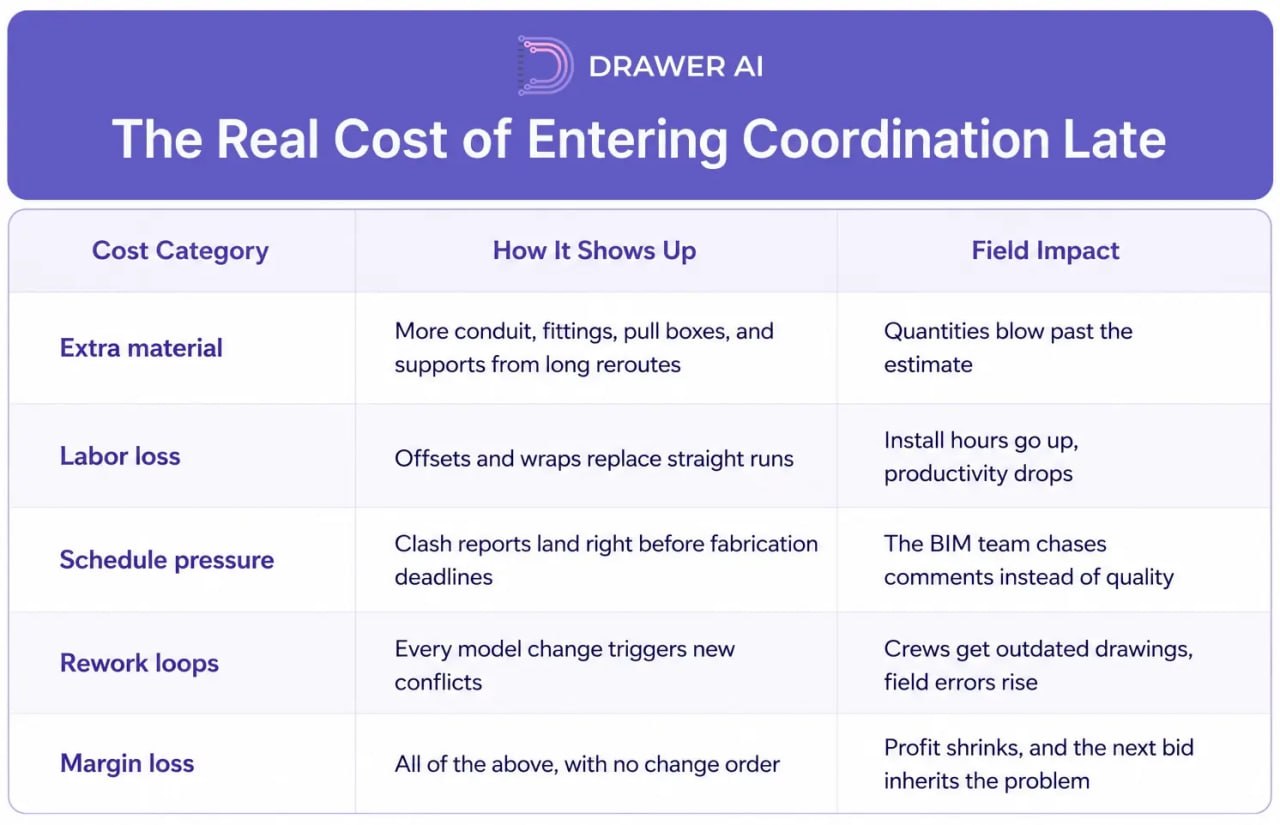

Cost Category

How It Shows Up

Field Impact

Extra material

More conduit, fittings, pull boxes, and supports from long reroutes

Quantities blow past the estimate

Labor loss

Offsets and wraps replace straight runs

Install hours go up, productivity drops

Schedule pressure

Clash reports land right before fabrication deadlines

The BIM team chases comments instead of quality

Rework loops

Every model change triggers new conflicts

Crews get outdated drawings, field errors rise

Margin loss

All of the above, with no change order

Profit shrinks, and the next bid inherits the problem



There is a quieter cost too. Teams that keep absorbing reroutes stop pushing for better answers. Coordination turns reactive, and the pattern repeats on the next job because the workflow never changed.

How to Win Space Back: Model First

The fix is easy to say and hard to do. Model fast enough to get into the coordination model before other trades take the main corridors. When your feeders, cable trays, and racks are in the model first, every meeting after that feels different.

If the electrical detailer lays out the main feeder banks and rack assemblies before mechanical locks in its duct runs, the clash software starts flagging the ducts as the problem. Now the mechanical team spends its hours routing around your work. That is the exact reversal you want.

Getting that speed means cutting out the slow manual work at the start of the job. Pull the design data out of the 2D drawings fast and turn it into 3D geometry before the coordination clock runs out. The workflow looks like this:

  1. Extract device data, circuit numbers, panel schedules, and equipment locations from the PDF drawings automatically instead of sheet by sheet.
  2. Group the data into logical circuits and note the routing limits from the building geometry.
  3. Generate branch and feeder routes from that data, using the other trades' Revit models for accuracy.
  4. Export the finished geometry into Revit and Navisworks in native formats.
  5. Walk into the first meeting with your systems already in place. You are now defending space, not begging for it.

Best Practices That Keep You Winning

Speed gets you the space. Good habits keep it. Here is what strong electrical teams do on every project.

  • Model major systems first. Feeders, cable trays, busways, and large conduit banks have the fewest routing options. Get them in early. Branch circuits can fit around them later.
  • Build in code clearances. Model the NEC 110.26 working space around every panel, switchboard, transformer, and MCC. Catch soft clashes before the meeting, not after install.
  • Check constructability, not just geometry. A clash-free model is only useful if electricians can build it. Think about ladder access, support spacing, pull box access, and what every offset costs in labor.
  • Talk between meetings. Waiting a week to raise a conflict slows the whole job. Share updated models and flag issues as they come up.
  • Keep strict version control. Track every revision and send it to everyone affected. Crews working from an old drawing is one of the most common causes of rework.
  • Claim corridors before the first meeting. Tell the general contractor early where your main runs need to go. Declared space gets negotiated. Undeclared space gets taken.
  • Document every reroute. Track the extra hours and material each forced move costs you. That record protects your margin and backs up change order requests when the reroutes pile up.

A Hospital Example

Take a six-story hospital with heavy mechanical scope. Under the old workflow, the electrical team spends three weeks reading drawings, sizing conduit, and routing by hand before its first file is ready. By then mechanical owns every main corridor, plumbing has its risers in, and fire protection has the rest.

Electrical enters the model and finds over two hundred hard clashes. Most of them land on electrical to fix. Every reroute adds offsets and pull boxes that spill into the next area and create new clashes. A six-week coordination plan turns into four months, and field productivity numbers stop meaning anything.

Under a faster workflow, the same team processes the drawings in days, generates routing automatically, and shows up to the first meeting with its systems in the model. Mechanical routes its ducts around the electrical work. Clashes still happen, but they get fixed on screen, early. Coordination finishes on time and crews build from a stable model.

Conclusion

Electrical contractors have accepted for too long that their conduit is the thing that moves. That is not engineering. It is a timing problem baked into how electrical design data gets delivered.

The trade that fills the model first keeps the corridors. When electrical teams get fast enough to model before the ceiling fills up, the whole dynamic flips. Other trades route around you. Rework drops. Productivity holds. Margins improve.

Book a demo to see how faster 3D electrical modeling helps your team coordinate earlier and protect conduit routes before other trades fill the space.

You do not win this by arguing harder in meetings. You win it by killing the delay between getting the drawings and delivering coordinated 3D geometry. That is where the space war is actually decided.

FAQs

What is the difference between a hard clash and a soft clash?

 A hard clash is two parts in the same physical space, like a conduit through a beam. A soft clash is a part inside a required clearance zone without touching anything, like piping in the working space in front of a panel. Both must be fixed. Hard clashes block the install. Soft clashes create code violations that last the life of the building.

Why do electrical conduits always get moved?

 Two reasons. Conduit is the most flexible system in the ceiling, so it looks like the cheapest fix. And electrical teams usually enter the model last because their drawings take longer to turn into geometry. By then the good corridors are taken, so moving the conduit is the easy call.

What tools are used for clash detection?

 Navisworks is the standard for combining models and running clash scans. Trade models are usually built in Revit. Issue tracking runs through tools like BIMcollab and Revizto. On the front end, automated extraction tools that turn 2D PDFs into 3D geometry are becoming common for electrical.

Can automation actually speed this up?

 Yes, and electrical has the most to gain from it. Software can now read PDF drawings, pick out devices and symbols, pull panel schedule data, group circuits, and generate routing paths. That removes the slow interpretation work that makes electrical late. Detailers can populate the model days or weeks earlier and take the corridors first.

What is the project manager's role in coordination?

 A big one. The PM keeps the timeline honest, gets structural and architectural files to the VDC team fast, tracks hours spent on forced revisions, and confirms crews get the right drawing version. Without that, even a good model loses value.

What is MEP coordination in construction?

 It is the process of combining the mechanical, electrical, plumbing, fire protection, and structural models into one shared 3D environment before construction starts. The goal is to find and fix every space conflict, code issue, and sequencing problem on screen instead of in the field. One missed clash can cost thousands in rework and lost schedule, so this is one of the highest-value steps on any commercial job.

What is clash detection?

 It is an automated check run inside the combined 3D model, usually in Navisworks. The software scans every trade model and flags each spot where parts overlap or break a required clearance. Fixing those hits in the model costs a few hours. Fixing the same problem in the field can mean cutting out installed work, reordering material, and losing schedule days.

What is the difference between a hard clash and a workflow clash?

 A hard clash is a physical overlap that makes the install impossible, like a conduit through a beam. A workflow clash is a schedule conflict, not a physical one. One trade needs a ceiling that another trade already closed, or a delivery route is blocked by finished work. Clash software cannot see workflow clashes. They only get solved by planning install sequences together.

Why is electrical coordination harder than other trades?

 Because electrical drawings do not give the detailer real geometry. Mechanical drawings show duct sizes. Plumbing drawings show pipe diameters and slopes. Electrical drawings are just symbols, circuit numbers, and panel schedule references. The detailer has to read every symbol, size every conduit from fill calculations, and route the whole system from scratch. That takes longer, so electrical is always behind on the clock.

How does BIM reduce clashes on commercial projects?

 BIM moves the problem-solving from the job site into a digital model before anything gets fabricated. When every trade contributes a full 3D model, the software catches overlaps and clearance issues automatically, and fixing them costs a fraction of a field fix. It also improves communication between trades, makes material buying more accurate, and gives crews a stable model to build from.
